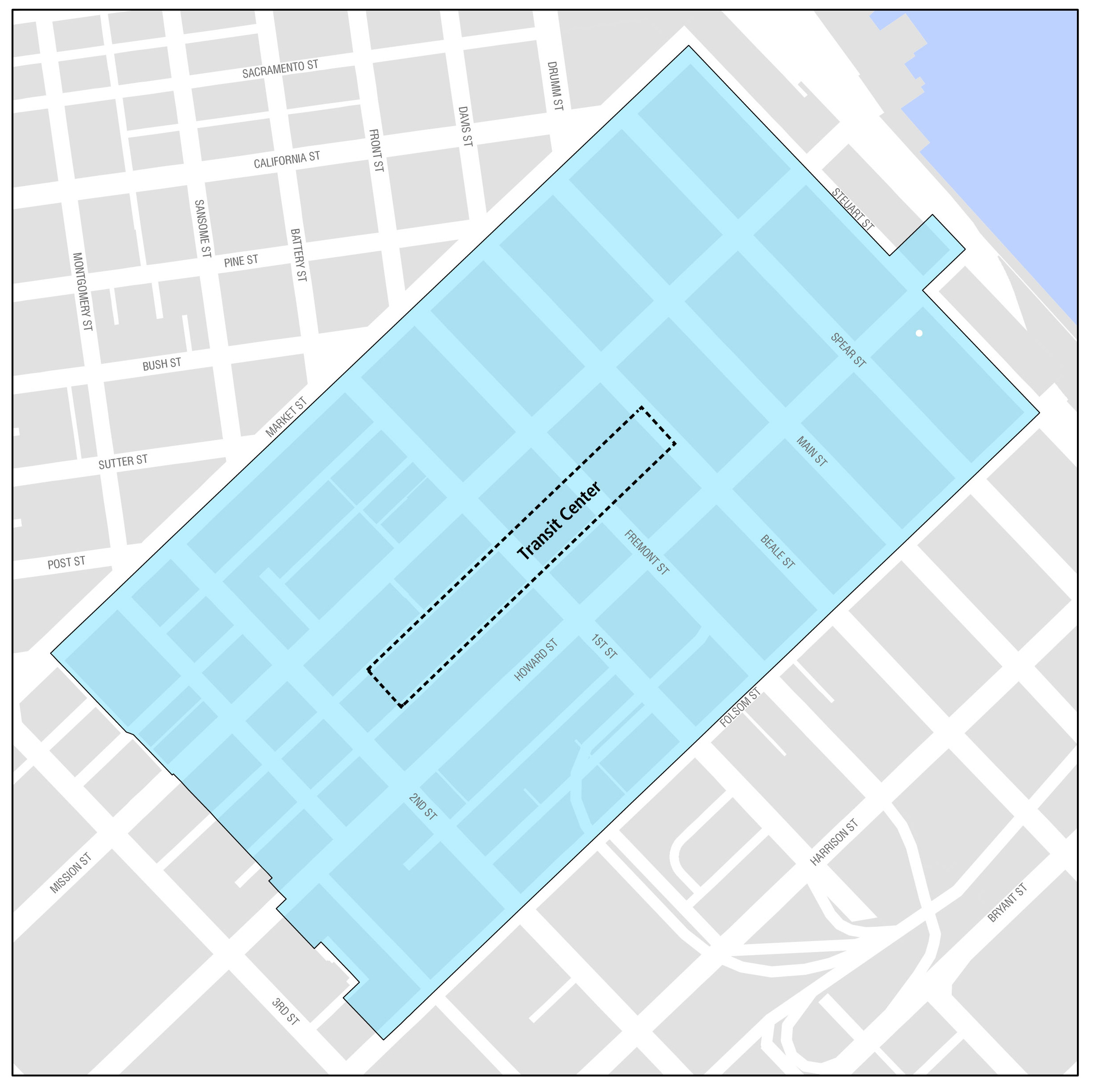

Transit Center

Transit Center

The Transit Center District Plan was adopted in 2012 to provide infrastructure improvements in conjunction with the opening of the Salesforce Transit Center. The Salesforce Transit Center is a $2.6 billion transportation hub to replace the old Transbay Terminal and will connect 11 regional transportation providers to downtown San Francisco. In addition to passengers arriving at the Transit Center, the Plan also includes several commercial developments.

The complete streets, transportation, and open space projects are designed to accommodate all of the new people that will arrive in the area each day. The Plan includes those projects to be implemented by City agencies, with additional projects to be completed by external agencies such as the Caltrain Downtown Extension (known as DTX), BART underground pedestrian connector, open space projects to be performed by the Office of Community Investment and Infrastructure, and sustainable resource district projects.

In addition to Impact Fees as a primary source of funding infrastructure projects, the Transit Center District Plan has also implemented a Community Facilities District (CFD) special use tax that will provide funding for projects in the neighborhood. The total revenues estimated for the proposed projects in the Transit Center District is $373 million, including prior years. The tables on the following page show the Transit Center District spending plan, sources of funds, and funding gap.

South Downtown Design and Activation Plan: The Planning Department is engaged in a multi-agency process to develop a comprehensive vision for the design, implementation and stewardship of the public spaces within San Francisco's South Downtown Area (composed of the Transit Center and Rincon Hill planning areas). This plan will inform infrastructure improvements designed to foster vibrant streets and open spaces, support high performing transit operations, and encourage active transportation choices for the people who live, work and visit the district.

Return to Impact Fee Areas

Key Proposed Eastern Neighborhoods Projects through 2029
COMPLETE STREETS

District-wide Streetscape and Pedestrian Improvements

Mid-block Crossings Signalization Changes
Casual Carpool Waiting Area
TRANSIT

Caltrain Downtown Extension (DTX)

BART Station Capacity Improvements
Congestion Charging Pilot Transit Delay Mitigation
RECREATION AND OPEN SPACE

Portsmouth Square Improvements

2nd & Howard Park
Hub Open Space Improvements



SPENDING PLAN
(Dollars in Thousands)
Prior Years FY
2020
FY
2021
FY
2022
FY
2023
FY
2024
FY 2025 - 2029 Plan Total

Complete Streets

68,378

10,817

1,000

750







12,567

Open Space 53,038 - - - - - - -
TOTAL 121,416 10,817 1,000 750 - - - 12,567

REVENUES

Impact Fees

96,503

11,068

1,728

834

-

-

49,278

62,907

Bonds 19,789 3,767 - - - - - 3,767
Other Local 18,456 - - - - 172,000 - 172,000
TOTAL 134,748 14,834 1,728 834 - 172,000 49,278 238,674
                Cumulative
Annual Surplus (Deficit)

13,332

4,018 728 84 -  172,000 49,278 239,439
